How dependency graphs and automated impact analysis prevent cascade failures in regulated product development.


The Change That Changed Everything

A design engineer updates a single requirement in a medical device design history file. The change is minor — a dimensional tolerance tightened by 0.2 millimeters based on manufacturing feedback. The engineer updates the requirement, revises the associated design input, and submits the change for review.

Three months later, during a pre-submission audit, the regulatory team discovers that the tolerance change invalidated 12 verification test protocols, 3 design validation test reports, 2 risk analysis entries, 1 supplier specification, and 4 standard operating procedures. None of these downstream documents were updated. The test data on file no longer demonstrates that the current design meets the current requirements.

The pre-submission timeline slips by four months. The remediation effort consumes 800 person-hours. The company misses its market window and a competitor launches first.

This is not an edge case. In organizations that manage design controls with document-centric tools — Word files, spreadsheets, and shared drives — this scenario plays out with disturbing regularity. The root cause is always the same: the system has no way to trace the downstream impact of an upstream change before the change is made.

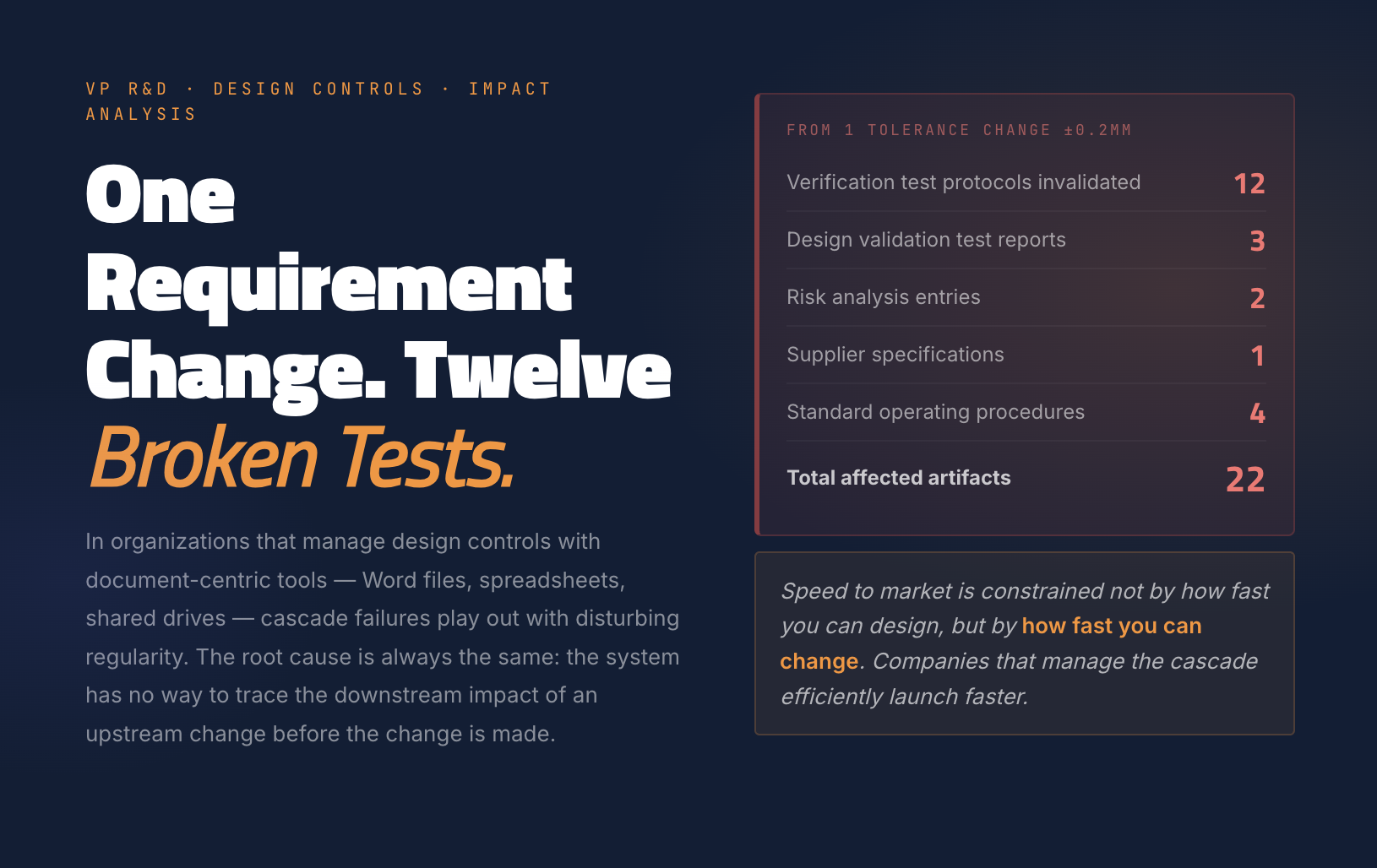

QAtrial – One Requirement Change, Twelve Broken Tests
VP R&D · Design Controls · Impact Analysis
One Requirement
Change. Twelve
Broken Tests.
In organizations that manage design controls with document-centric tools — Word files, spreadsheets, shared drives — cascade failures play out with disturbing regularity. The root cause is always the same: the system has no way to trace the downstream impact of an upstream change before the change is made.
From 1 Tolerance Change ±0.2mm
Verification test protocols invalidated12
Design validation test reports3
Risk analysis entries2
Supplier specifications1
Standard operating procedures4
Total affected artifacts22
Speed to market is constrained not by how fast you can design, but by how fast you can change. Companies that manage the cascade efficiently launch faster.
Case Study: The Cascade Discovered at Pre-Submission Audit
1 Tolerance Change. Discovered 3 Months Later. 800 Person-Hours. Missed Market Window.
Cascade Map — What Changed, What Broke
REQ-087: Dimensional Tolerance ±0.2mm tightened
12 Verification test protocols — test pass/fail criteria no longer valid against tightened tolerance Invalidated
3 Design validation test reports — executed against the prior tolerance, results no longer applicable Outdated
2 Risk analysis entries — severity/probability calculations based on original tolerance Stale
1 Supplier specification — acceptance criteria referenced pre-change dimensional requirement Misaligned
4 SOPs — assembly and inspection procedures referenced old tolerance in work instructions Non-current
800 hrs
Remediation effort · discovered at pre-submission audit
+4 months
Pre-submission timeline slip
Missed market window
Competitor launched first
The pre-submission discovery is not the worst outcome. The worst outcome is a field failure — when the cascade goes undetected through submission and reaches the market. The DHF showed 22 inconsistencies. The test data no longer demonstrated that the current design met current requirements.
The Scale of the Problem
How Many Traceability Links Are in Your Design History File?
Class I / Simple Class II
Total traceability links
50 design requirements × typical chains of 2–4 links (requirement → spec → test → result). A moderately complex device that can be managed manually — barely.
Typical Class II Medical Device
Total traceability links
100–200 requirements, each tracing through specifications, verification activities, risk analysis entries, and design transfer SOPs. Too large for any individual to know completely.
Class III / Combination Product
Total traceability links
Full risk management integration, software IEC 62304 traceability, human factors engineering, and clinical evidence chains multiply the link count to a scale that makes manual management effectively impossible.
When a single node in this network changes, every connected node must be evaluated for impact. In a manual system, that evaluation depends on someone knowing the full extent of the traceability network. No individual has that knowledge for a complex device. The network is too large, too interconnected, and changes too frequently.
What Impact Analysis Actually Requires
Three Capabilities Most QMS Tools Do Not Provide
01
A Live Dependency Graph
Not a traceability matrix in a spreadsheet — a graph data structure where requirements, specifications, tests, risk items, documents, and training records are nodes, and the relationships are edges. Every link is a first-class data entity with type, status, creation date, and author. QAtrial maintains this graph as a core data structure — not metadata annotations on documents.
Queryable at any time · Always current
02
Automated Impact Calculation
When an engineer selects a requirement and indicates intent to modify it, the system traverses the dependency graph and returns every downstream artifact affected — before the change is executed. Directly affected items (linked to the changed requirement) and indirectly affected items (linked to directly affected items) are returned in a structured impact report with owner and status.
Pre-change · Not post-audit discovery
03
What-If Scenario Modeling
Model the impact of a change without making it. For complex design issues with multiple solution options, each option has a different impact profile. Side-by-side comparison of impact scenarios changes the change control conversation from “what do we need to change?” to “which change path minimizes downstream disruption while achieving the design objective?”
Compare paths before committing
What-If Scenario Modeling — Real Example
Class II Diagnostic Device · Sample Handling Mechanism · Three Options Evaluated
Impact Analysis Before Committing to Any Option
A Best technical characteristics Not selected
8
Requirements affected
34
Downstream artifacts
~800h
Estimated update effort
B Same reliability improvement · 1/3 the impact ✓ Selected
3
Requirements affected
12
Downstream artifacts
~400h
Estimated update effort
C Intermediate option Not selected
5
Requirements affected
22
Downstream artifacts
~550h
Estimated update effort
Engineering hours saved by selecting Option B over Option A — same reliability improvement, one-third the downstream disruption.
~400 hrs saved
Device Profile: Class II Diagnostic
Design requirements120
Design output specifications85
Verification protocols95
Risk control measures40
Standard operating procedures30
Total traceability links~1,800
Without impact analysis, the team would likely have selected Option A — the best technical option — and discovered the full downstream impact months later during a design review. The impact analysis shifted the selection from best-technical to best-total-outcome.
The Cost of Missing Impact Analysis
Three Cost Categories — Each Measurable, Each Avoidable
Audit Remediation
$20K–$100K
200–1,000 hrs × $100/hr
Per missed cascade
Retroactive impact assessment, document revision, re-verification, and in some cases re-validation for a single missed cascade. This is the most visible cost — it appears on the CAPA record.
Submission Delays
$10M+
6-month delay on $20M/yr product
Deferred revenue per delay
A 510(k) or CE marking submission with traceability gaps receives a deficiency letter, adding 3–12 months to approval. For a product with $20M projected first-year revenue, a 6-month delay costs $10M in deferred revenue.
Product Quality Risk
Recall
Most serious consequence
When cascade reaches the market
When a design change is not propagated through verification and validation, the company loses assurance that the product meets its design requirements. This is not a documentation problem — it is a design assurance problem that can result in field failures.
Integration with Change Control
Impact Report as a Mandatory Part of Every Change Request
1
Engineer initiates a design change request and selects the affected requirement(s) in QAtrial
2
Impact analysis runs automatically — dependency graph traversed, impact report generated as part of the change request record
3
Change review board reviews impact report. Cannot approve the change until every affected artifact is dispositioned (confirmed unaffected, assigned for revision, or flagged for re-verification)
4
Upon approval, QAtrial creates follow-up tasks for every artifact requiring updating — assigned, tracked, and verified
5
Change request is not closed until all downstream updates are verified complete — creating a closed-loop process
🔒
Approval gated on full disposition
No change can pass through the control process with undispositioned downstream artifacts. The gap that creates cascade failures cannot occur because the system prevents it.
Post-change verification tracked
Every artifact requiring update gets a tracked task with assigned owner, due date, and completion verification. The change request status reflects real-time downstream update progress.
📋
Audit-ready change record
The change request record contains: original impact analysis, disposition decisions, update tasks, completion evidence, and effectiveness verification — the complete paper trail an auditor expects, assembled automatically.
🔄
Bidirectional traceability maintained
As downstream artifacts are updated, their links are updated. The dependency graph stays current. Future impact analyses are always calculated against the actual current state of the design.
The Dependency Graph as a Strategic Asset
Beyond Change Control — Three Strategic Capabilities
🏗️
Architectural Risk Identification
Requirements with an unusually high number of downstream dependencies are single points of failure in the design control system. The dependency graph surfaces these architectural risks before a change is initiated — not after a cascade is discovered.
High-fan-out requirements
🔬
Test Coverage Gap Detection
Requirements with no verification links, or verification activities that cover multiple requirements and may mask individual failures, are visible in the graph. Find coverage gaps before the auditor does — not during a pre-submission review.
Unlinked requirements surfaced
📊
Platform Change Planning
When a major design change is contemplated — platform revision, next-generation architecture, product line extension — impact analysis shows the full scope of effort before the first engineering hour is spent. Accurate project planning, not surprise discoveries that derail timelines and budgets.
Scope known before kickoff
The dependency graph is not just a compliance tool. It is a strategic instrument for VP R&D leaders who need to understand the true cost of architectural decisions before committing engineering resources. Navigate with a map — not in the dark.
“The companies that manage the cascade efficiently launch faster. The companies that discover cascade failures during audits launch late — or don’t launch at all.
🕸️
Live dependency graph. Every requirement, spec, test, risk item, SOP, and training record linked as a queryable graph — not metadata annotations on Word documents.
Pre-change impact calculation. The 22 affected artifacts in the case study would have appeared in an impact report before the tolerance change — not three months later at the pre-submission audit.
🔀
What-if scenario modeling. Option A vs B vs C — same objective, different downstream impact. ~400 engineering hours saved by choosing the right path before committing.
💰
$0 license cost · 25+ data models · 80+ API endpoints. Deploy the dependency graph on your infrastructure. See the cascade before it falls.
Impact Mapping: Making a Big Impact with Software Products and Projects

Impact Mapping: Making a Big Impact with Software Products and Projects

As an affiliate, we earn on qualifying purchases.

As an affiliate, we earn on qualifying purchases.

The Scale of the Problem

Medical device design control under 21 CFR 820.30 and ISO 13485 Section 7.3 requires traceability between design inputs, design outputs, verification, validation, and design transfer. This traceability is not optional — it is the backbone of the design control process and the primary subject of every design history file audit.

A typical Class II medical device has 50 to 200 design input requirements. Each requirement traces to one or more design output specifications. Each specification traces to one or more verification activities — tests, analyses, or inspections. Verification results trace to validation protocols. Risk analysis entries in the risk management file trace to both requirements and mitigations.

The total number of traceability links in a moderately complex device can exceed 2,000. In a Class III device or a combination product, the number can reach 10,000 or more.

When a single node in this network changes, every connected node must be evaluated for impact. In a manual system, that evaluation depends on someone — usually the design engineer who initiated the change — knowing the full extent of the traceability network. In practice, no individual has that knowledge for a complex device. The network is too large, too interconnected, and changes too frequently for any person to hold it in their head.

The result is incomplete impact assessment. Changes are made without full understanding of their downstream consequences. Cascade failures accumulate silently until they surface during an audit, a regulatory review, or — worst case — a field failure.

katerk 6pcs Red&Black Bit Holder with Carabiner Socket for Mens Gift, 1/4 inch Hex Shank Aluminum Alloy Screwdriver Bit Holders, Quick Release Easy Change Impact Driver Drill Bit Keychain Extension

katerk 6pcs Red&Black Bit Holder with Carabiner Socket for Mens Gift, 1/4 inch Hex Shank Aluminum Alloy Screwdriver Bit Holders, Quick Release Easy Change Impact Driver Drill Bit Keychain Extension

Great Compatibility: This Katerk 1/4 inch hex shank bit holder is specifically designed for 1/4" hex shank drill…

As an affiliate, we earn on qualifying purchases.

As an affiliate, we earn on qualifying purchases.

What Impact Analysis Actually Requires

Effective impact analysis in a regulated design environment requires three capabilities that most QMS tools do not provide.

A Live Dependency Graph

The first requirement is a structured, queryable dependency graph that represents every traceability link in the design control system. This is not a traceability matrix in a spreadsheet — it is a graph data structure where requirements, specifications, tests, risk items, documents, and training records are nodes, and the relationships between them are edges.

QAtrial maintains this graph as a core data structure. Every requirement is linked to its downstream specifications. Every specification is linked to its verification protocols. Every verification protocol is linked to its results. Every risk control measure is linked to both the hazard it mitigates and the verification activity that demonstrates its effectiveness. Every SOP is linked to the design transfer requirements it supports. Every training record is linked to the documents that generated the training requirement.

These links are not metadata annotations on documents. They are first-class data entities with their own attributes — link type, link status, creation date, and the identity of the person who established the link.

Automated Impact Calculation

The second requirement is the ability to calculate the full impact of a proposed change before the change is executed. When an engineer selects a requirement and indicates an intent to modify it, the system traverses the dependency graph and returns every downstream artifact that may be affected.

QAtrial’s impact analysis engine performs this traversal automatically. The output is a structured impact report that lists every affected artifact by type, owner, and current status. The report distinguishes between directly affected artifacts — those linked to the changed requirement — and indirectly affected artifacts — those linked to the directly affected items.

For the tolerance change example at the opening of this article, the impact analysis would return all 12 test protocols, all 3 validation reports, both risk analysis entries, the supplier specification, and all 4 SOPs — before the engineer makes the change. The engineer and the change review board see the full scope of impact at the point of decision, not months later during an audit.

What-If Scenario Modeling

The third requirement is the ability to model the impact of a change without actually making it. In complex design environments, there are often multiple ways to address a design issue. Each option has a different impact profile. The ability to compare impact scenarios before committing to a change path enables better decision-making.

QAtrial supports what-if analysis by allowing engineers to select any node in the dependency graph and simulate a change. The system calculates the impact cascade for each scenario, presenting the results side by side. The change review board can evaluate not just the technical merits of each option but the downstream effort required to implement it.

This changes the change control conversation from “what do we need to change?” to “which change path minimizes downstream disruption while achieving the design objective?”

Environmental Management in Practice: Vol 1: Instruments for Environmental Management

Environmental Management in Practice: Vol 1: Instruments for Environmental Management

As an affiliate, we earn on qualifying purchases.

As an affiliate, we earn on qualifying purchases.

The Cost of Missing Impact Analysis

The financial impact of inadequate impact analysis manifests in several ways.

Audit remediation is the most visible cost. When an auditor discovers that downstream documents were not updated after a design change, the finding triggers a CAPA that requires retroactive impact assessment, document revision, re-verification, and in some cases re-validation. For a single missed cascade, the remediation effort ranges from 200 to 1,000 person-hours. At $100 per hour for engineering staff, that is $20,000 to $100,000 per incident.

Submission delays are the most expensive consequence. Regulatory submissions — 510(k)s, PMAs, CE marking technical files — require complete and consistent design history files. A submission that contains traceability gaps will receive a deficiency letter, adding 3 to 12 months to the approval timeline. For a product with $20 million in projected first-year revenue, a 6-month delay costs $10 million in deferred revenue.

Product quality risks are the most serious concern. When a design change is not propagated through the verification and validation chain, the company loses assurance that the product meets its design requirements. This is not a documentation problem — it is a design assurance problem that can result in products that do not perform as intended.

Amazon

automated impact analysis for medical devices

As an affiliate, we earn on qualifying purchases.

As an affiliate, we earn on qualifying purchases.

Integration with Change Control

Impact analysis is most effective when it is integrated with the formal change control process. In QAtrial, a design change request automatically triggers an impact analysis. The impact report becomes part of the change request record, reviewed and approved as part of the change control workflow.

The change request cannot be approved until every affected artifact has been dispositioned — either confirmed as unaffected, assigned for revision, or flagged for re-verification. This ensures that no change passes through the control process without a complete accounting of its downstream consequences.

Post-change verification is tracked automatically. When the change is approved, QAtrial creates follow-up tasks for every artifact that requires updating. Each task is assigned, tracked, and verified. The change request is not closed until all downstream updates are complete.

This creates a closed-loop change control process where every change is fully propagated through the design control system. Audit findings related to incomplete change propagation become virtually impossible because the system prevents the gap from occurring.

The Dependency Graph as a Strategic Asset

Beyond change control, the dependency graph provides strategic visibility into the design’s structure. VP R&D leaders can use the graph to identify architectural risks — requirements with an unusually high number of downstream dependencies, which represent single points of failure in the design control system. They can identify test coverage gaps — requirements with no verification links, or verification activities that test multiple requirements and may mask individual failures.

The graph also supports resource planning. When a major design change is contemplated — a platform revision, a next-generation architecture, or a product line extension — the impact analysis shows the full scope of the effort before the first engineering hour is spent. This enables accurate project planning and resource allocation, not the surprise discoveries that derail timelines and budgets.

A Practical Example

A Class II diagnostic device manufacturer maintains 120 design requirements traced to 85 design output specifications, 95 verification protocols, 40 risk control measures, and 30 SOPs. Total traceability links: approximately 1,800.

The R&D team proposes a change to the device’s sample handling mechanism to improve reliability. Three design approaches are under consideration, each affecting a different subset of requirements.

Using QAtrial’s what-if analysis, the team evaluates the impact of each approach. Option A affects 8 requirements with 34 downstream artifacts. Option B affects 3 requirements with 12 downstream artifacts. Option C affects 5 requirements with 22 downstream artifacts.

Option B achieves the reliability improvement with one-third the downstream impact of Option A. The team selects Option B, saves approximately 400 engineering hours in downstream updates, and maintains the submission timeline.

Without impact analysis, the team would likely have selected the option with the best technical characteristics — Option A — and discovered the full impact of that choice months later during the design review.

The VP R&D’s Competitive Advantage

Speed to market in regulated industries is constrained not by how fast you can design, but by how fast you can change. Every design iteration triggers a cascade of downstream activities. The companies that manage that cascade efficiently launch faster. The companies that discover cascade failures during audits launch late.

QAtrial’s impact analysis engine gives your R&D team the visibility to make change decisions with full knowledge of their consequences. It is the difference between navigating with a map and navigating in the dark.

The dependency graph is available as part of QAtrial’s open-source platform — 25+ database models, 80+ API endpoints, zero license fees. Deploy it on your infrastructure, link your design artifacts, and start making informed change decisions.


Build your dependency graph with QAtrial at github.com/MeyerThorsten/QAtrial. See the cascade before it falls.
